Add a project- or task-specific allocation
Allocations can be added manually at the task or project level. Allocations can also be created automatically when adding tasks, if this feature has been enabled in the settings.
First, select whether you want to view the Allocations view by project or by member.
View grouped by project
- Go to the project row and click the arrow.
- Select whether to add the allocation at the project or task level:
- At the project level: Click the arrow on the Direct allocations row, and draw a bar on the calendar for the desired day/week/month next to the appropriate project team member.
- For a task shown in the list: Click the arrow on the task row, and draw a bar on the calendar for the desired day/week/month next to the appropriate task member. (If the person is missing from the list, first select Edit task members.)
- For another task: Click Add task row, select a previously created task and Add, or create a New task. Then follow the instructions in the previous step.

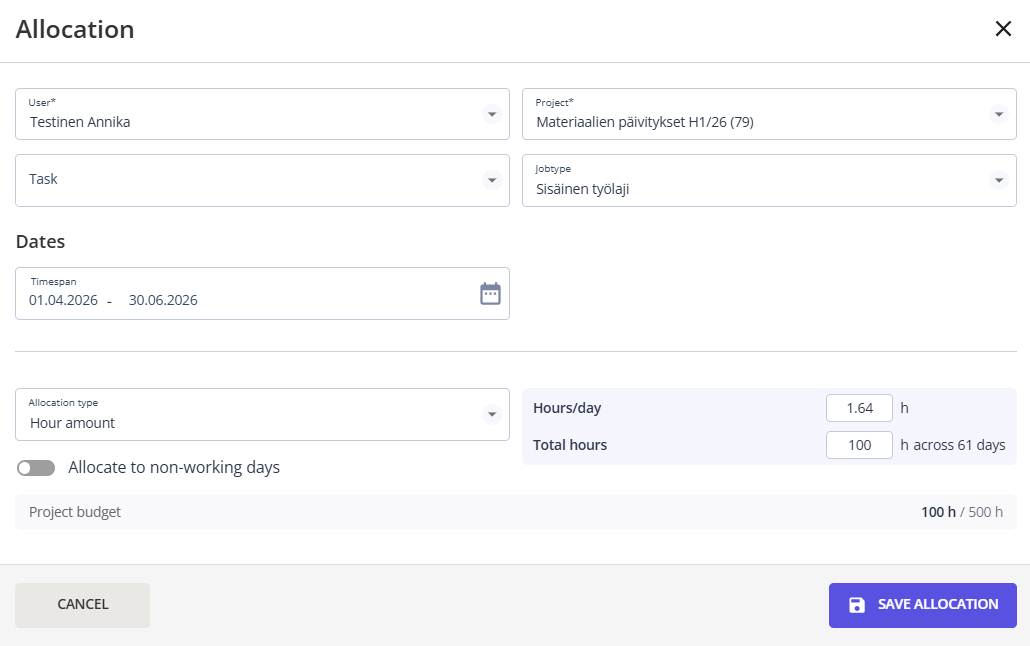

- Complete the allocation details in the window that opens. The allocation can be defined as:
-a total hour amount per day or period, or
-hours per specific days, or
-as a %-share of the expected working time per day or period, if it is a single user. . - Save allocation.
The added allocation is now displayed on the rows.

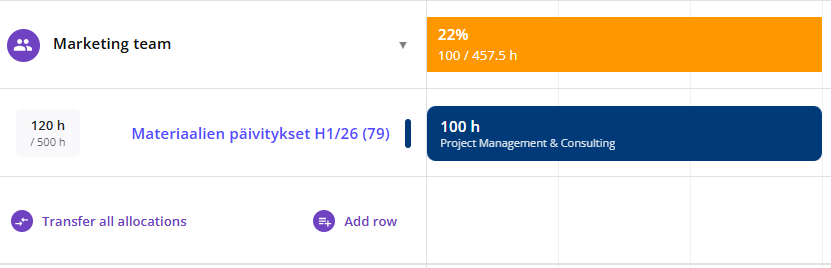

- On the project row, you can see the amount allocated per day/week/month.
- On the header rows, you can see how much time was originally budgeted for the project or task and how much of it has been allocated.
View grouped by member
- Go to the user’s or placeholder’s row and click the arrow.
- Select Add row.
- Select a project or task from the drop-down list > Add.
- Draw a bar on the project or task row that appears in the calendar for the desired day/week/month period.
- Complete the allocation details in the window that opens. The allocation can be defined as:
-a total hour amount per day or period, or
-hours per specific days, or
-as a %-share of the expected working time per day or period, if it is a single user.
At the bottom you can see the Project budget meaning the total hours allocated + budgeted for the project. -
Save allocation.
The added allocation is now visible on the rows.
- On the staff member’s/placeholder’s row you will see the updated utilization (allocated hours/expected working time).
- At the beginning of the project or task row you will see how much time was originally budgeted for the project or task, and how much of it has been allocated.
Add an allocation by copying
If you add allocations manually (rather than having them added automatically when tasks are created), you can also create a new allocation by copying the details of a previous allocation.
- Double-click the allocation bar on the person's row.
- In the new window, select Actions > Copy allocation.
- The application will ask you to confirm the action.
- The details of the previous allocation will be used as the basis for the new allocation. Make the necessary changes and select Save allocation.
View allocations
At the top of the Resourcing > Allocations view, first filter the basic selections:
- Display: select whether the allocations should be grouped by project or member, and the sorting of projects.
-
Metric: select which figures are viewed, when grouped by member:

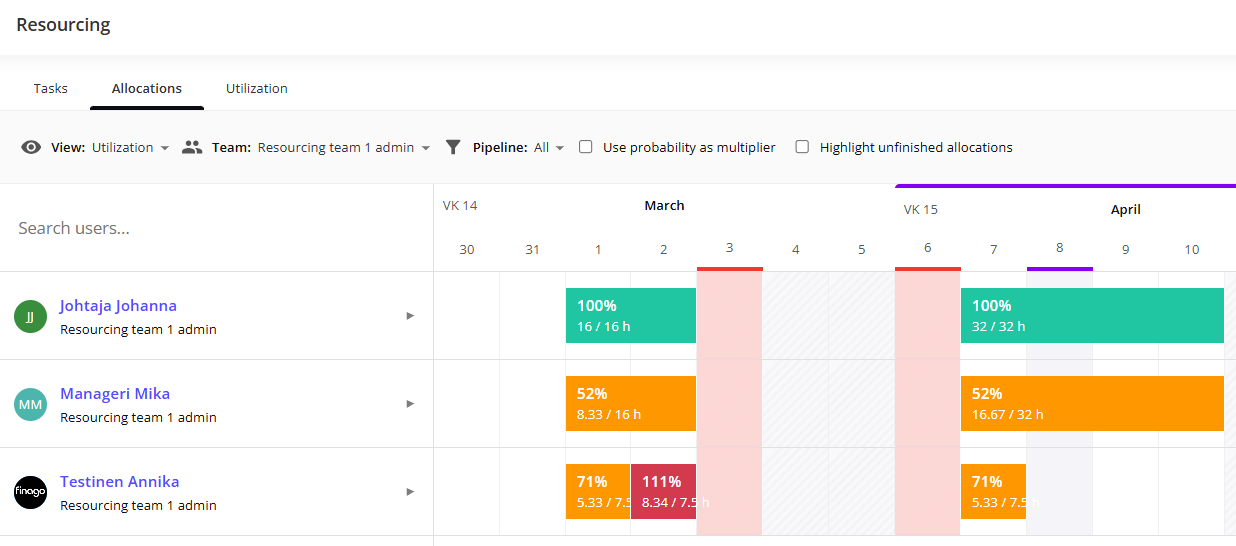

- Utilization: allocated hours / expected working time
- Billable rate: allocated billable hours / all allocated hours
- Allocated hours: absolute allocated hour amounts.
-
Filters: if needed, filter the search results by:
- Team
- Pipeline
- Project
-

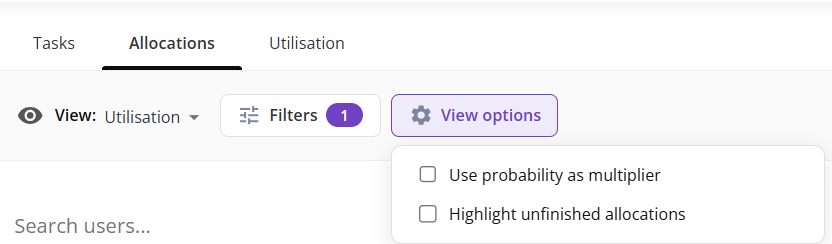

View options:
- Use probability as multiplier: The pipeline stage probability percentage can be used as a multiplier for allocations. This provides an estimate of the likely workload of the allocations.
- Highlight unfinished allocations: You can highlight past allocations for which users did not track hours.
Choose whether to display data at the day, week, or month level. You can move horizontally with the arrows.
You can also expand the view to full screen.
The template shows staff working days in white, days off in gray with lines, and public holidays in red.

An allocation is shown as a bar. An allocation that extends over days off is indicated with dashed lines.
An allocation that matches the expectation is shown in green, one that falls short in yellow, and one that exceeds it in red.
The total hours of each column (day, week or month) is shown at the top of the grid.
Edit or delete allocations
If the program has created the allocation automatically from a task (you have enabled the setting Add allocations automatically when saving a task), it is recommended to make any necessary changes (or delete the allocation) directly on the task. When prompted by the program, save the same changes to the task allocations as well. This ensures that the task and its allocations remain consistent.
If the allocation was created manually in the Allocations view:
- Double-click the allocation bar on the person's row.
- Select Edit allocation (or Actions > Delete).
- Make the necessary changes and select Save allocation.
Transfer allocations to another user/team

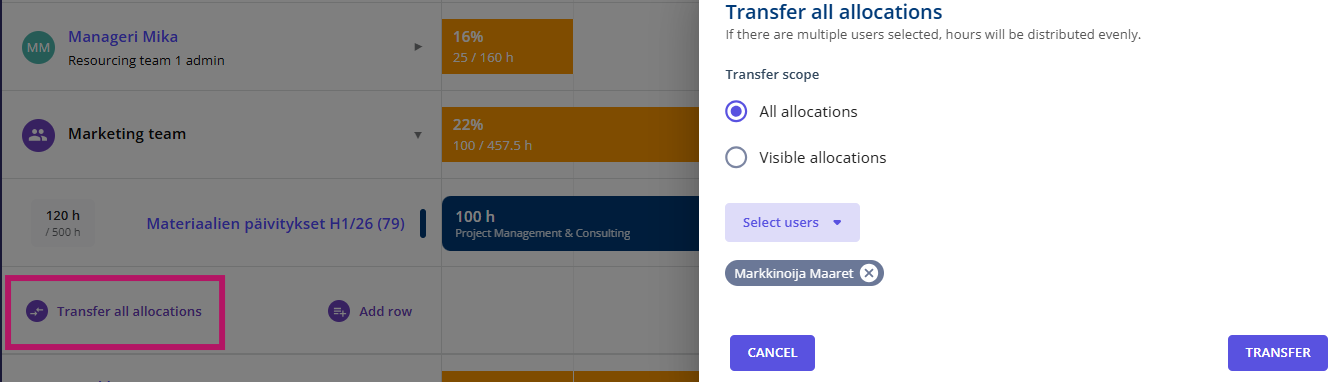

You can transfer a user’s or placeholder’s allocations to another user, for example if an allocation was made for a placeholder during the planning phase and later you want to distribute it to actual users.
- Go to the placeholder’s row and click the arrow.
- Select Transfer all allocations (if the view is grouped by projects, this can be seen when the cursor is on the row) .
- Select all allocations (all in future) or visible allocations (the allocations you had horizontally limited to the view).
- Select the user/team to which the allocations will be transferred and click select.
- Click Transfer.
Utilization
Utilization view works the same way as New reports > Users > Utilization report, meaning you can monitor and report what share of users’ expected working time for a given period has been allocated to projects or tasks.
By default utilization is calculated from allocations. If you do not use allocations feature at all, there is a setting in general resourcing settings that allows you to calculate utilization rates from tasks' budgeted hours.
